What Really Determines IBC Production Line Cost? A Buyer’s Total-Investment Model

Views: 3     Author: Site Editor     Publish Time: 17-07-2026      Origin: Site

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
kakao sharing button
snapchat sharing button
sharethis sharing button
What Really Determines IBC Production Line Cost? A Buyer’s Total-Investment Model

The price shown on an IBC machine quotation is rarely the same as the amount required to start stable commercial production. A buyer may receive one proposal for a blow molding machine, another for a “complete line,” and a third for a turnkey plant. All three can appear to answer the same inquiry while covering completely different responsibilities.

A more useful question than “How much does an IBC production line cost?” is: “What investment is required to produce an accepted IBC at my factory, at my target volume, with my required container design?” That question forces the project team to include the equipment, tooling, utilities, building work, installation, labor, quality systems, and working capital that determine real performance.

This article uses a total-investment model rather than a simple price list. It does not provide a universal number because the correct figure depends on product specifications and local conditions. Instead, it shows where the budget goes and how to compare proposals without overlooking expensive exclusions.

Cost IBC 1: The Core IBC Inner-Tank System

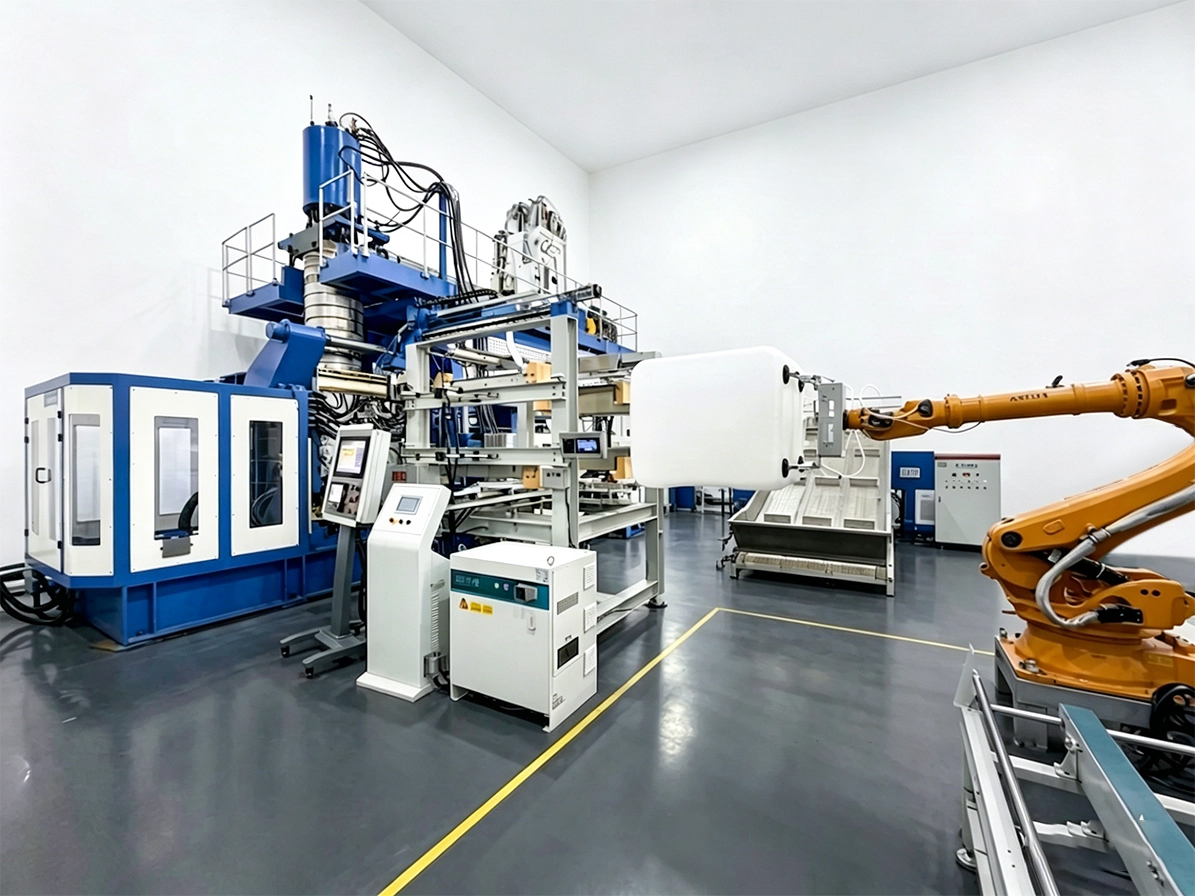

The IBC tank blow molding machine is usually one of the largest items in the project. Its cost changes with container size range, layer configuration, extrusion capacity, accumulator-head design, clamping system, parison controller, automation, control components, and production target.

A machine intended only for one standard bottle may have a simpler scope than a platform designed for several capacities and molds. Two-layer and three-layer systems also differ because additional extruders, dosing equipment, controls, and material circuits increase complexity. High-output configurations may need larger plasticizing capacity, stronger cooling, faster handling, and more capable downstream equipment.

Buyers should confirm whether the quoted blow molding package includes:

Resin loading and conveying

Gravimetric or volumetric dosing

Color or additive mixing

The complete extrusion and accumulator-head system

Parison wall-thickness control

Mold and mold cooling connections

Deflashing and trimming equipment

 Bottle conveyors or handling

Crusher and scrap-return equipment

Leak testing

Startup spare parts and consumables

If a low-priced proposal excludes the mold, cooling equipment, compressor, loader, mixer, crusher, and tester, the final investment may be much higher than expected.

Cost IBC 2: The Steel Cage and Pallet Section

An IBC inner bottle cannot become a complete composite container without its protective cage and base. Cage manufacturing can involve tube preparation, cutting, welding, bending, clinching or locking, punching, frame forming, pallet welding, and inspection fixtures.

The cost changes significantly according to the source of tubes. A factory that buys prepared tubes needs a different line from one that forms or mills tubes in-house. Automation also matters. Manual transfer between operations reduces initial investment but requires more labor, floor space, and work-in-process. Automatic loading, robotic unloading, and integrated transfer increase capital cost but can improve repeatability and reduce handling.

When comparing cage-line proposals, ask whether the quotation includes welding transformers, fixtures, electrodes, tube racks, unloading devices, guards, cooling, and the machines needed after grid welding. A quotation for one welding machine is not a quotation for a cage production system.

Pallet design also affects investment. Plastic, steel, composite, or customer-specific bases may require different equipment and suppliers. The cage and pallet must match the bottle dimensions and final assembly method, so tooling and interfaces should be evaluated together.

Cost IBC 3: Assembly, Testing, and Finishing

The assembly area is sometimes underestimated because it may look less complex than blow molding or welding. In practice, it can determine labor cost, throughput, traceability, and final defect rate.

A complete scope may include bottle insertion, cage positioning, pallet connection, valve installation, closure installation, torque control, valve welding where applicable, conveyors, lifting systems, leakage testing, weighing, labeling, coding, and stacking.

The correct level of automation depends on output and local labor. A semi-automatic assembly line may be suitable for a new plant that needs flexibility. A high-volume factory may need synchronized stations and automatic data collection. Buyers should calculate operators per shift and accepted containers per operator, not just the price of the equipment.

Testing equipment should be specified by method and performance. Pressure range, holding time, test accuracy, rejection system, calibration, data storage, and connection to production records can all affect cost. A simple pass/fail tester and a traceable quality-control station are not equivalent.

Cost IBC 4: Tooling and Product Development

Molds, fixtures, gauges, and change parts are capital assets, not minor accessories. The cost of an IBC blow mold depends on size, material, cooling design, neck and outlet inserts, surface features, venting, manufacturing precision, and expected production life.

If the project includes 500L, 800L, 1000L, and 1200L products, each mold and related changeover system must be included. The cage line may also need different fixtures or programs for different designs. Assembly stations may need alternate supports, valve tools, and gauges.

Product development can require sample trials, resin testing, bottle-weight optimization, wall-thickness mapping, dimensional adjustment, and performance validation. This engineering work creates long-term value because material savings or improved cycle time repeat on every unit. Buyers should not treat mold and process development as a commodity purchase.

Cost IBC 5: Utilities and Factory Preparation

An IBC production line can be delivered on time and still remain idle because the building is not ready. Utility and site costs may include:

Transformer and electrical distribution

Cabling, panels, grounding, and power-quality protection

Cabling, panels, grounding, and power-quality protection

Air compressors, dryers, filters, receivers, and air piping

Foundations, floor reinforcement, and anchor work

Ventilation and extraction

Drainage and water treatment

Cranes, lifting beams, and mold-handling equipment

Fire protection and safety systems

Material storage and conveying infrastructure

Warehouse racks and forklift routes

Local climate changes the calculation. A plant in a hot region may need more cooling capacity than one using cold process water. Poor water quality can require treatment and increase maintenance. Unstable power may justify additional protection. The buyer should obtain a utility schedule before finalizing the building design.

Cost IBC 6: Installation, Training, and Ramp-Up

Machine price may or may not include overseas technician service, travel, accommodation, translation, installation tools, local labor, trial resin, and production training. These terms must be written clearly.

Installation is not the end of the project. Ramp-up involves tuning material temperatures, parison profiles, cooling, deflashing, handling, welding parameters, assembly methods, and testing. Operators need time to learn startup and shutdown procedures, fault recovery, recipe management, mold maintenance, and quality checks.

A realistic budget includes trial material, scrap during commissioning, technician time, calibration, and a period of lower efficiency. Ignoring ramp-up cost can create cash-flow pressure exactly when the factory is beginning production.

Cost IBC 7: Working Capital and Inventory

Before the first customer pays, the plant may need to purchase HDPE resin, additives, tubes, valves, lids, pallets, labels, packaging materials, spare parts, and maintenance consumables. Finished IBCs occupy substantial warehouse space, and customer payment terms may extend the cash cycle.

Working capital is not part of the machinery quotation, but it is part of the project investment. The business plan should estimate raw-material days, work-in-process, finished-goods stock, receivables, and minimum spare-parts inventory.

For a multi-layer product, material inventory can become more complex because different resin streams and approved recycled material must be identified and controlled. Poor inventory planning can interrupt production even when all machines are available.

Cost IBC 8: Unit Cost After Startup

Purchase price affects depreciation, but operating cost determines competitiveness. A practical unit-cost model includes:

Unit cost = resin + additives + electricity + cooling + compressed air + direct labor + scrap loss + maintenance + tooling allocation + quality cost + packaging + overhead

Resin is often a major component, which makes bottle-weight control and scrap management commercially important. A machine that improves wall distribution may reduce unnecessary material while maintaining performance. The savings must be validated through testing, not assumed.

Energy should be calculated per accepted bottle. Connected power alone is not enough. Cooling load, compressor efficiency, heaters, hydraulics, conveyors, crushers, welders, and idle time contribute to the final number.

Labor depends on automation, factory discipline, material flow, and downtime. A cheap machine that needs constant manual correction can cost more over its life than a stable machine with a higher purchase price.

Three Budgeting Mistakes to Avoid

Mistake One: Comparing Different Scopes as if They Were Equal

Normalize quotations line by line. Create a responsibility matrix for every machine, mold, utility, service, and test. Mark who supplies it, who installs it, and whether it is included in the price.

Mistake Two: Using Maximum Output in the Financial Model

Build the base case around conservative accepted output. Include maintenance, changeovers, quality checks, operator learning, and market demand. Use maximum output only as an upside scenario.

Mistake Three: Buying Automation Without a Bottleneck Analysis

Automation should remove a real constraint. If the market needs only moderate output, a complex high-speed assembly system may not improve return. If labor is expensive and traceability is critical, under-automation can be equally costly. Match investment to the business case.

A Better Way to Request a Quotation

Provide suppliers with one standard inquiry package. Include product drawings or samples, desired capacity range, bottle weight, layers, resin, target output, cage and pallet design, test requirements, workshop layout, ceiling height, power standard, cooling-water conditions, compressed-air conditions, automation preference, and desired project boundary.

Ask for three commercial numbers:

1. Equipment and tooling investment

2. Estimated site and utility requirements

3. Estimated operating consumption under defined production assumptions

Also request an optional expansion plan. A modular phase-one line may offer a stronger return than purchasing the largest available system immediately.

Price Is a Number; Investment Is a System

The lowest IBC machine price does not necessarily create the lowest-cost IBC. The economically correct line is the one that produces consistent accepted containers, uses material efficiently, matches sales demand, can be maintained locally, and can grow without major reconstruction.

When buyers evaluate all eight cost IBCs, the quotation becomes a decision tool rather than a promotional document. The project team can identify exclusions, calculate realistic cash needs, compare total cost, and select a full automatic IBC production line or modular configuration that fits the company’s actual stage of growth.

Suggested Internal Links

Suggested Image Alt Text

IBC Full Production Line

IBC production line cost breakdown for machinery tooling and utilities

1000L IBC Tank Blow Molding Machine

complete IBC machine investment including blow molding cage welding and assembly

IBC Cage Production Equipment

IBC plant utility system with cooling water compressed air and electrical supply

IBC Mold and Auxiliary Machinery

IBC production cost calculation based on accepted containers
